Politics & Government

Updated: KDOT delays 24 road projects amid budget uncertainty

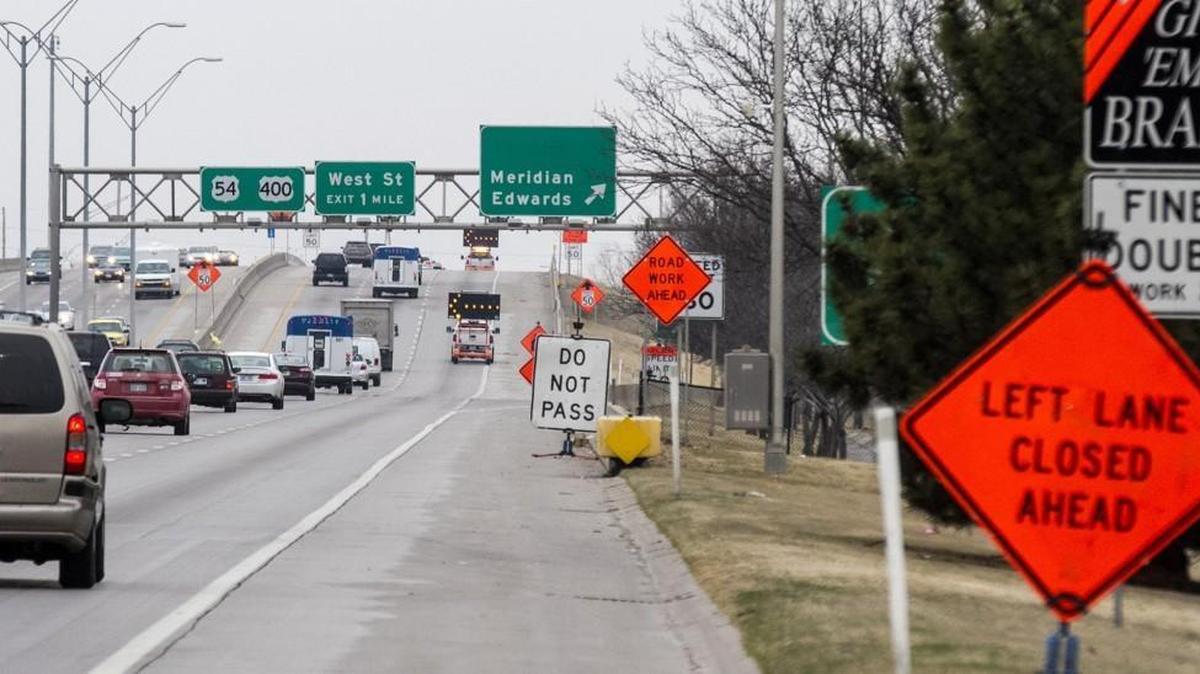

Lanes on Kellogg to West Street. KDOT is delaying 24 road projects because of budget concerns. (Feb. 23, 2016)
Lanes on Kellogg to West Street. KDOT is delaying 24 road projects because of budget concerns. (Feb. 23, 2016) Eagle file photo

Editor’s note: This story was updated to reflect a change in the number of projects affected.

The Kansas Department of Transportation has indefinitely postponed 24 road projects in the face of the state’s budget shortfall.

The department said Monday that 14 projects estimated to cost $32 million had been postponed. It said Tuesday that number was incorrect and should be 24. The overall cost is the same.

KDOT had planned to put the projects up for bid in December but decided to postpone them after it was announced last week that the state faces a $350 million budget gap.

“Until we know more about what our funding is going to be going forward, we just can’t commit to all the projects that we originally planned for December,” said Steve Swartz, spokesman for the agency.

The postponed projects include a $3.3 million resurfacing of U.S. 50 in Harvey County and a $1.4 million resurfacing of U.S. 77 in Cowley County.

The agency will move forward with 10 projects that will cost a total of $8 million, including a $2.7 million paving project in Derby.

Swartz said the agency will make decisions about whether to approve projects on a “month by month basis.” He added that while these projects were set to go up for bid next month, construction would not have taken place until the summer.

“There’s no emergency work or anything like that,” Swartz said. “So if they were going to start in the summer, there would still be time (to do the projects) if we can.”

The current fiscal year runs through June. The state faces an even bigger budget gap of $582 million for the fiscal year beginning July 1.

Bob Totten, the executive vice president of the Kansas Contractors Association, called the postponement of the projects disappointing for both contractors and communities.

“These projects equate to safety and efficiency of the road system, and when you cut projects because of the diversion of funds, you have problems,” Totten said. “You’re endangering the safety of our citizens. And it’s just unfortunate on a lot of levels. We’re not going to have jobs. We’re not going to be able to provide product to market as quickly and as efficiently as we should. And we’re not going to have the safety of people who want to go to a football game on a Friday night.”

Gov. Sam Brownback has swept more than $1 billion from the state’s highway fund since 2011, using it in recent years to help plug budget holes. KDOT in April announced the delay of 24 roads projects that were set to begin this or next fiscal year.

Bryan Lowry: 785-296-3006, @BryanLowry3

Postponed KDOT projects

County

Highway

Type of project

Estimated cost

Brown

US73

Surfacing

$420,000.00

Brown

US36

Surfacing

$785,000.00

Cloud/Jewel

K28

Surfacing

$1,948,000.00

Douglas

US56

Surfacing

$2,148,000.00

Jefferson

US24

Surfacing

$973,000.00

Jefferson

K16

Surfacing

$2,260,000.00

Johnson

US56

Surfacing

$862,000.00

Marshall

K009

Bridge Replacement

$2,400,000.13

Nemaha

K63

Surfacing

$947,000.00

Riley

US24

Surfacing

$385,000.00

Ottawa

K106

Surfacing

$663,575.00

Saline

K143

Surfacing

$565,345.00

Bourbon/Crawford

K3

Surfacing

$1,086,000.00

Cherokee

US69

Surfacing

$398,000.00

Cherokee

US400

Surfacing

$388,000.00

Franklin

I035

Bridge replacement

$2,724,181.95

Labette

K101

Surfacing

$307,074.30

Neosho

U059

Surfacing

$1,677,225.00

Wilson

K47/75

Surfacing

$664,000.00

Woodson

K105

Surfacing

$543,342.53

Cowley

US77

Surfacing

$1,371,260.50

Harvey

US50

Surfacing

$3,298,892.58

Finney

US50

Reconstruction

$3,931,290.15

Seward

US54

Intersection Improvement

$1,710,484.62

Source: Kansas Department of Transportation
